Sprint Burndown & Burnup

Overview

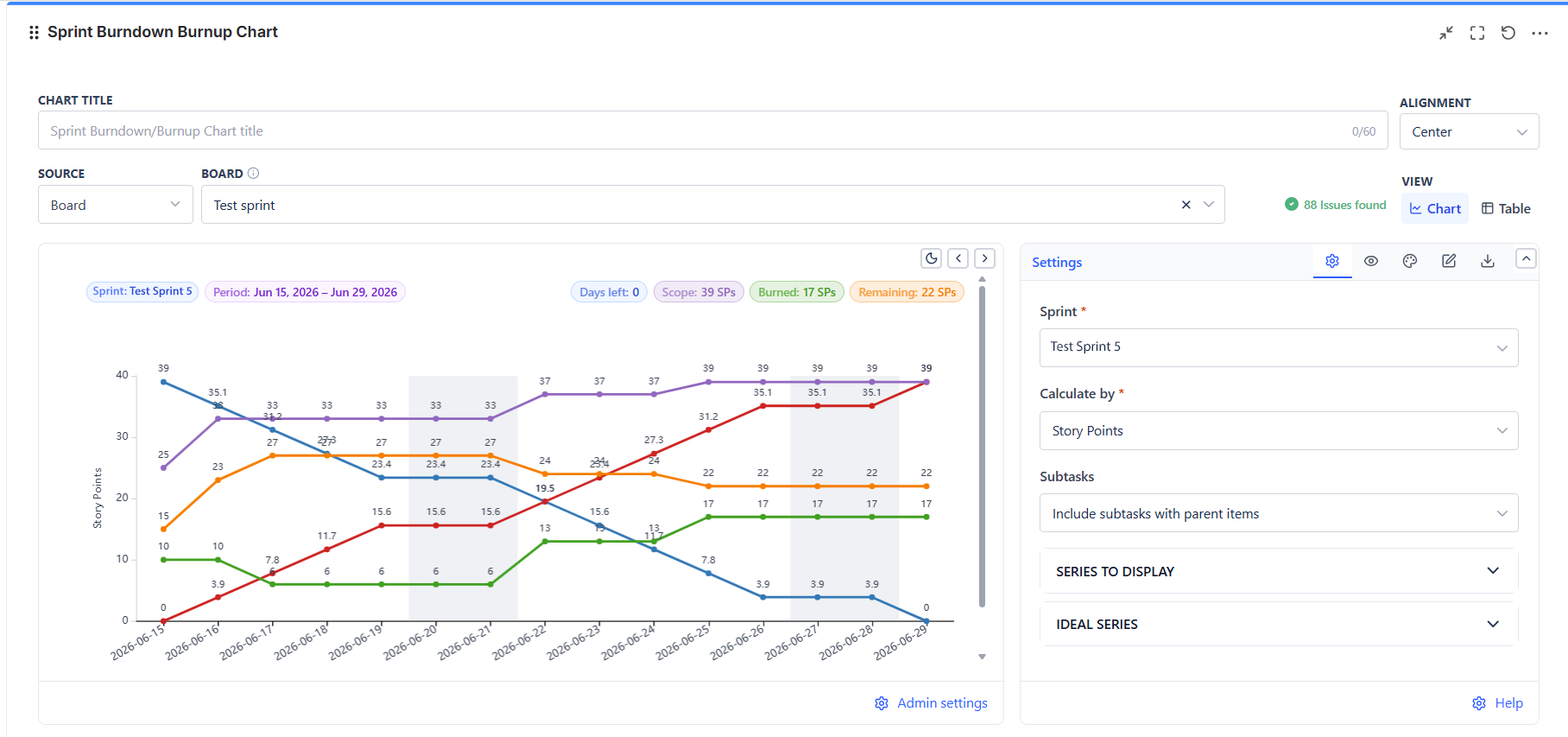

This gadget is board-scoped by design: you pick a board, then a sprint on that board. Sprint dates, scope, and completion all come from the sprint itself, so the chart matches what the team committed to.

Overview

FeatureDescription
Five SeriesRemaining, Burned, Scope, Ideal Burndown, and Ideal Burnup - each toggled independently
Seven MeasuresStory points, story point estimate, original estimate, remaining estimate, time remaining and spent, work item count, or a numeric custom field
Scope LineShows scope changes mid-sprint - the single most useful series for retrospectives
Configurable DoneDefine completion by the board's last column or by an explicit status list
Weekend HandlingTreat weekends as working or non-working days, or hide them entirely
Data Table ViewThe per-day numbers behind every series

How to Read Each Series

SeriesReads As
RemainingWork still open. Should fall towards zero
BurnedWork completed so far. Should rise
ScopeTotal committed work. A flat line means a stable sprint
Ideal BurndownStraight line from full scope to zero - the pace needed to finish on time
Ideal BurnupStraight line from zero to full scope - the mirror image, for teams who prefer counting up

Reading the Shape

  • Remaining above ideal = behind pace. The gap at any day is roughly the catch-up needed
  • Remaining flat then dropping at the end = work finished in a batch. Predictable-looking totals, unpredictable delivery
  • Scope line stepping up mid-sprint = work was added after commitment. This explains a "failed" sprint more often than slow delivery does
  • Remaining rising = new work is arriving faster than existing work closes
  • Both remaining and ideal hitting zero together = a well-paced sprint

Action pattern: In sprint review, read the scope line first. If it moved, the burndown was never going to land where it was drawn - and that is a planning conversation, not a delivery one.

Board and Sprint Selection

  1. Pick the board - only Scrum boards have sprints
  2. Pick the sprint, or choose Latest sprint (auto) so the gadget follows the active sprint and never needs re-editing

Auto-latest is the right choice for any dashboard that stays up across sprints. Pick a specific sprint only for a fixed retrospective report.
