Time in Status Gadget

Work Schedule & Time Formats

Control how elapsed time is measured - calendar time (every hour) or business hours only (excluding nights, weekends, and non-working hours).

Why This Matters

By default, Time in Status counts every hour - including nights, weekends, and public holidays. An issue that sat untouched over a 3-day weekend accumulates 72 hours against its age.

If your SLA commitments are stated in business days (e.g., "resolve P1 issues within 2 business days"), calendar time gives a misleading picture. Business-hours calculation gives the number that actually reflects your team's working capacity.

Time Format Options

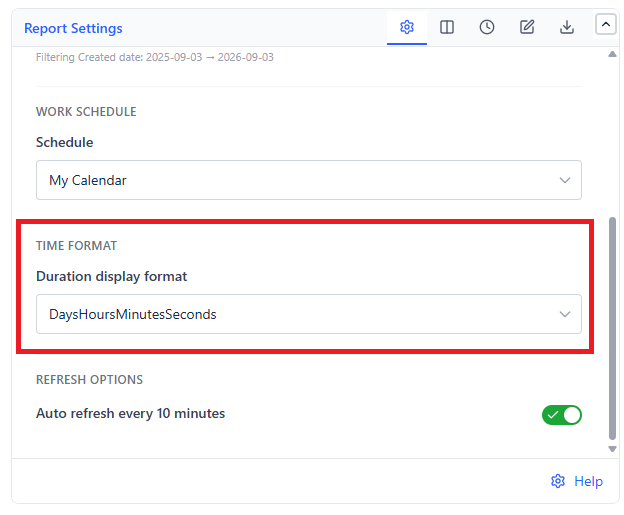

Work Schedule and Time Format settings

The Duration display format setting, in the Report Settings tab, controls both the unit and whether business hours are used:

FormatTypeExample
Business DaysHoursMinutesBusiness hours2d 3h 15m
Business Decimal DaysBusiness hours2.4 days
Business Decimal WeeksBusiness hours0.48 weeks
Decimal DaysCalendar time2.4 days
Decimal HoursCalendar time57.6 hours
Decimal WeeksCalendar time0.34 weeks
DaysHoursMinutesSecondsCalendar time2d 9h 36m 0s
Hours:MinutesCalendar time57:36
HoursMinutesCalendar time57h 36m
MinutesCalendar time3456 min

Rule: Any format starting with "Business" uses your Work Schedule. All others use calendar time (24/7).

Work Schedule Configuration

To use business-hours calculation, configure your team's work schedule first.

How to Set Up a Work Schedule

  1. Open the Work Schedule tab in the Time in Status gadget settings
  2. Give the schedule a name (e.g., "DEV Team schedule") - you can keep several and reuse them
  3. Select which days of the week are working days (e.g., Mon-Fri)
  4. Set the working hours - a start time and an end time
  5. Optionally add Breaks and Holidays (see below)
  6. Save the schedule

Breaks

A break is a daily window that does not count as working time - a lunch hour, for example. Give it a start time, an end time, and a label.

Breaks are subtracted from every working day, so an 09:00-17:00 day with a 1-hour lunch counts as 7 hours, not 8.

Holidays

A holiday is a full day that does not count at all. Give it a date and a name.

Tick Repeat every year for fixed-date holidays like New Year, so you do not have to re-enter them each year. Leave it off for dates that move.

Several schedules

You can create more than one schedule, duplicate an existing one as a starting point, and delete ones you no longer need - useful when teams in different regions have different working days or holidays.

Applying the Work Schedule

Once your Work Schedule is saved, go to the Report Settings tab and do two things:

  1. Pick the schedule in the Schedule dropdown
  2. Set Duration display format to a "Business" format (e.g., "Business Decimal Days")

The gadget then excludes non-working hours - and any breaks and holidays on that schedule - from every time calculation.

Practical Example

An issue moved to "In Review" on Friday at 5pm and out on Monday at 9am.

CalculationResult
Calendar time64 hours (full weekend counted)
Business hours (8h/day, Mon–Fri)0 hours (no working time elapsed over the weekend)

The business hours result accurately reflects that no one was actually reviewing the issue over the weekend.
